Project Claim Management

Project contracts describe project claim management procedures because we need them in implementation and closure phase in order to resolve problem situations that are not covered by the contracts’ change management clauses. Usually, that means that the change is already executed but any payment for additional effort or penalties for delays are not yet agreed upon.

In sub-section Project Contract Management we illustrate the fundamentals of successful project claim management:

  • Contractual Basis
  • Records
  • Claim Strategy

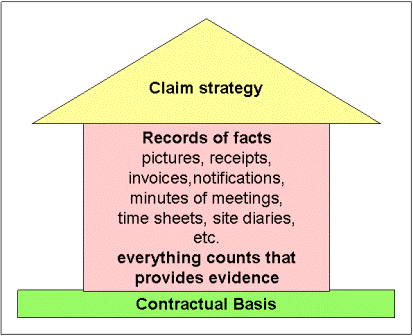

Fundamentals of a Successful Claim

Hence, a good claim preparation consists of three steps:

Step 1: Analysis of contracts

We identify all rights and obligations of the involved parties, the relevant clauses and their possible interpretations and the project claim management procedures we have to comply with. The following diagram shows a general project claim management procedure.

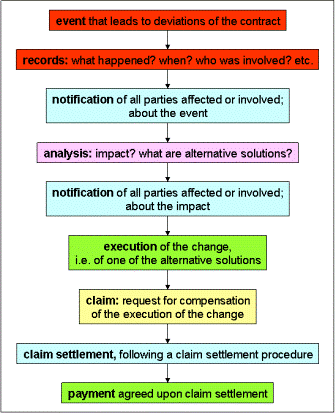

Claim Management Process

We note that there must be at least notifications of the event itself and of the impact that event would have. Certainly, we should find these notifications in our collection of records.

Step 2: Analysis of records

There will be records available that refer to the problem situation which is under dispute. Each one of these records or documents should hold the date when it was created. This gives us a time line of the chain of events and the correspondence about them. Possible records are:

  • Contract between Customer and Supplier
  • Contracts between Supplier and Sub-suppliers
  • Project Site Diary
  • Drawings
  • Pictures
  • Movie clips
  • Design Documentation
  • Delivery Notes
  • Invoices
  • Receipts
  • Time Sheets
  • Minutes of Meetings
  • Instructions – Confirmation of Instructions
  • Letters
  • Notifications to Involved or Affected Parties
  • Daily Reports - Weekly Reports - Project Status Reports
  • Cost Calculation
  • Notes of phone calls
  • E-Mails

Most important result of this step is a clearly structured list, the so called time line of all records and documents relevant to the claim case. This list, in turn, forms an essential building block of the evidence of the claim and of project claim management in general. Here, we give an example illustrating a structured procedure that helps us to put this list together.

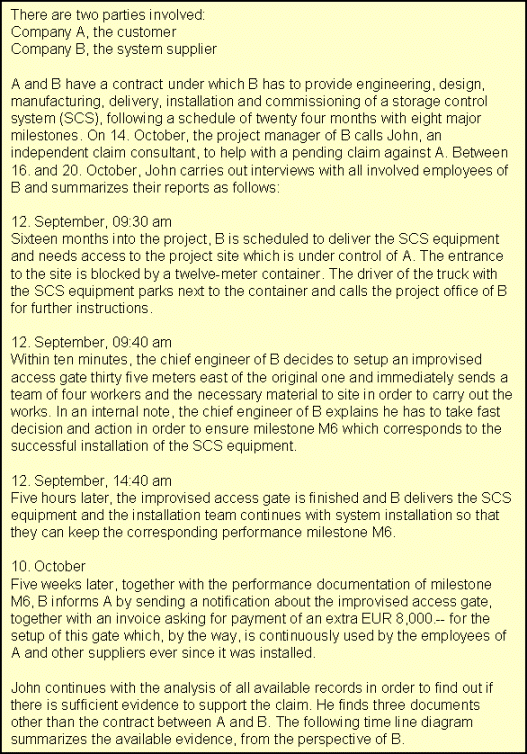

Claim Case Description

Claim Case Analysis

Please note that the time line of a claim case contains only relevant records that hold as evidence, no assumptions and no conclusions. We continue discussing this case in sub-section Project Claim Analysis.

Step 3: Analysis and decision of a claim strategy

Before we enter the escalation of the claim settlement procedure as it is laid down in the contract we always try to negotiate with the involved parties in order to find the most feasible solution. This negotiation needs a strategy which we only can prepare after obtaining a clear understanding of the underlying contracts with their possible interpretations and the available records. The claim strategy depends on our answers to the following questions:

  • In order to define the claim strategy the following questions can be helpful:
  • what relationship to our contractual partner do we want to keep?
  • what are the policies of our other involved or affected business units?
  • how does the claim correspond to the project goals?
  • how does the claim correspond to our general business goals?
  • who needs to be involved?
  • how solid is the evidence?

Claim documentation, letter and presentation

Good project claim management requires good project documentation. As soon as we collect all the relevant material of a claim case we need to file that material together with all the other project relevant documents. Even in case we decide not to pursue an “aggressive” claim strategy we need to inform the other involved parties of our view of any potential claim case, usually as required by the ruling contracts, i.e. in writing. Best practice content of such a letter or folder is

  • Executive summary: short and clear.
  • Records of relevant facts that constitute the evidence: the time line serves as list of content, which consists of the copies of the records.
  • Conclusion: clear reference to the records.

For the actual claim negotiation and further escalation we prepare a presentation of the whole case that helps all involved parties to get a clear overview.
