TEST 3



Lesson 3

Test 3



Question 1: What is the minimum descriptive content of a work package?
  • (A) Specification of the goal of the work.
  • (B) Prerequisites of the work in terms of tools and material.
  • (C) Description of the desired work result and its cost.
  • (D) Description of the work in terms of verb and object.
Your answer:

Question 2: What is the lowest level of a WBS?
  • (A) Sub-objects
  • (B) Work packages
  • (C) Project phases
  • (D) Work package descriptions
Your answer:

Question 3: Which of the following statements is correct?
  1. The WBS shall be free of contradictions.
  2. For each WBS we need a PBS.
  3. The WBS shall be free of redundancies.
  4. The PBS does not contain work packages.
  5. The lowest level of a WBS contains only work packages.
  6. The PBS shows all the work of the project.
Question 4: Determine the critical path (this is the core part of test 3; take paper, pen, and some time and try).

In order to work on this task you need the network diagram. Here you can download it: Network Diagram of the "Desk Project"

The following table contains estimated effort and duration of each work package of the desk example: effort in working hours (wh), duration in hours (h).

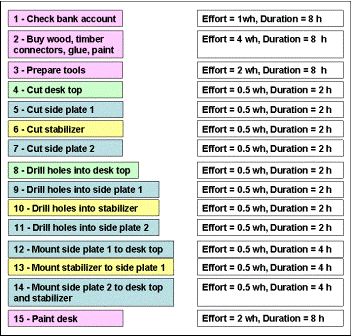

Desk Effort

How do we read this?
Let us take an example: For the work package "Prepare tools" we have
effort = 2 wh, duration = 8 h,
meaning that we will shift the actual work of preparing the tools, that block of 2 working hours, within a time frame of 8 hours, when ever it fits best.

Then, the critical path is ...
  • (A) 1 - 2 - 4 - 5 - 6 - 7 - 13 - 14 - 15.
  • (B) 1 - 3 - 4 - 5 - 6 - 7 - 13 - 14 - 15.
  • (C) 1 - 2 - 4 - 8 - 9 - 12 - 13 - 14 - 15.
  • (D) 1 - 2 - 4 - 5 - 6 - 7 - 11 - 14 - 15.
Your answer:

Question 5: What is the duration of the critical path?
  • (A) 38 h
  • (B) 40 h
  • (C) 42 h
  • (D) 44 h
Your answer:

Question 6: What is the total effort of that project, in wh?
  • (A) 10 wh
  • (B) 14.5 wh
  • (C) 38 wh
  • (D) 40 wh
Your answer:

Question 7: What helps us to prioritize risks?
  • (A) Calculating the probability of each risk.
  • (B) Multiplying probability with impact of each risk.
  • (C) Calculating the impact of each risk.
  • (D) Neither one of the above.
Your answer:
